Public research overview
Overhead Catenary Systems: Offerings, Buyers and Market Boundaries

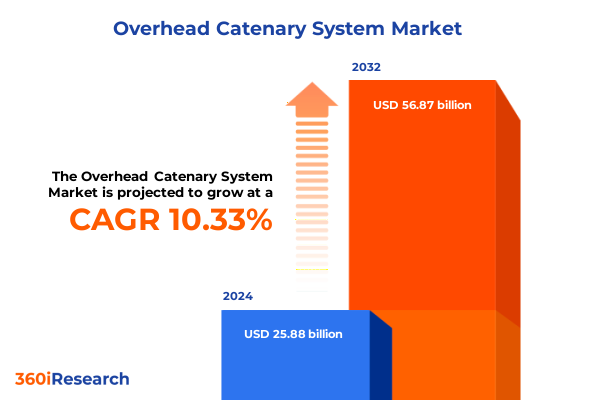

The Overhead Catenary System market connects railway power-collection infrastructure with buyers seeking reliable service, compatibility with existing assets and manageable lifecycle costs. The inspected commercial evidence covers conventional suspended contact-line systems, rigid overhead conductor rails, associated fittings and condition-monitoring offerings for mainline and urban rail.
Siemens' Sicat portfolio includes supports, tensioning equipment, insulators, overhead conductor rails and monitoring. Alstom describes in-house catenary design and manufacturing within a broader electrification portfolio. These offerings serve different business roles: component supply, packaged infrastructure delivery and ongoing asset support.
Market boundaries matter commercially. Rolling stock, traction substations and broader railway construction are related purchases, but are not interchangeable with OCS expenditure. Alstom also markets APS catenaryless feeding and SRS static ground-based charging; these are alternatives or adjacent categories, not overhead-catenary sales.
The practical opportunity therefore depends on who controls the package and what is being purchased: a new line, an extension, replacement components, a licensed system or monitoring support. A railway investment announcement alone does not establish an accessible catenary contract.
- Contact lines - Siemens Mobility Global (opens in a new tab)mobility.siemens.com
- Siemens markets contact-line systems and components for mainline and mass-transit railways, including supports, tensioning equipment, insulators, overhead conductor rails and monitoring.
- Empowering rail systems globally: Alstom's electrification capabilities (opens in a new tab)alstom.com
- Alstom describes in-house catenary design and manufacturing within a broader electrification portfolio that also includes power supply, substations, feeders and cabling.
- The portfolio separately identifies APS as a catenaryless solution and SRS as static ground-based charging.
Inside the research
Coverage at a glance
Selected branches from the published table of contents. Follow a chapter to see every subchapter in context.
Chapter 7 Region
- Asia-Pacific
- North America
- Latin America
- Europe
Chapter 8 Group
- ASEAN
- GCC
- European Union
- BRICS
Chapter 9 Country
- United States
- Canada
- Mexico
- Brazil
Ownership, Rigid Catenary and Licensing Reshape Competition
The competitive landscape is changing through control of products and access to project channels, not simply through railway construction announcements.
Mosdorfer Graph's March 2022 announcement records Knill's completed acquisition of Pfisterer's railway-products business at the end of December 2021, including associated intellectual property, facilities and personnel. This changed the commercial home of established tensioners and catenary fittings. It was an ownership transfer, not evidence of a new customer order.
On April 9, 2025, Alstom announced an agreement with RESA Yapi Elektromekanik to supply a Rigid Overhead Catenary System for part of Türkiye's Halkali–Kapikule high-speed line. The agreement demonstrates a cross-border component-supply role for rigid catenary, but does not itself establish delivery or operation.
HS2 illustrates a different competitive mechanism: Colas Rail's OCS package uses SNCF Réseau's V360 design under licence, with competitive purchasing from the components market. Such structures separate design ownership, systems delivery and component supply, potentially widening participation without making every supplier a systems prime.
- Pfisterer Rail Equipment acquisition by Mosdorfer / Knill Group, and ongoing equipment supply in Australia (opens in a new tab)mosdorfergraph.com.au
- Mosdorfer Graph's March 2022 announcement states that Knill acquired Pfisterer's railway-products business at the end of December 2021, including related intellectual property, manufacturing facilities and personnel.
- Alstom signs contract with RESA Yapi Elektromekanik A.S. to supply the first Rigid Overhead Catenary System for Türkiye's new high-speed line (opens in a new tab)alstom.com
- On April 9, 2025, Alstom announced an agreement with RESA Yapi Elektromekanik to supply a Rigid Overhead Catenary System for part of the Halkali–Kapikule high-speed line in Türkiye.
- Railway systems - HS2 (opens in a new tab)hs2.org.uk
- HS2 assigns the OCS package to Colas Rail, using the V360 design range under licence from SNCF Réseau.
- HS2 states that the licence allows the OCS contractor to purchase competitively from the components market.
AI Adds a Monitoring Proposition, Not Proven Market-Wide Returns
Public evidence establishes a specific AI use in overhead-line information work. Hitachi describes a six-month trial beginning in May 2022 on LNER Azuma trains on the East Coast Main Line, combining overhead-line imagery with machine-learning analytics and information for Network Rail. That account documents a trial, not universal operational adoption.
Hitachi now markets HMAX for Infrastructure with AI-supported pantograph and overhead-line video analysis in partnership with NVIDIA. Its September 24, 2026 announcement also describes catenary monitoring from in-service trains. The separate commitment to embed HMAX technology in all new rolling stock from 2027 remains forward-looking and concerns the broader platform; it is not a count of paid catenary deployments.
The cumulative commercial implication is a possible expansion from hardware supply into information and lifecycle services. That opportunity depends on customer data access, responsibility for decisions and evidence that customers purchase the service. Conventional monitoring must not automatically be counted as AI: the inspected Siemens Sicat CMS description does not label it as such.
This review did not establish market-wide AI adoption, independently measured OCS-specific savings, or material use of generative AI in catenary tendering and customer service. Supplier-reported benefits should therefore remain separate from demonstrated commercial returns.
- Contact lines - Siemens Mobility Global (opens in a new tab)mobility.siemens.com
- The inspected Sicat CMS description presents contactless catenary monitoring and filtered alarms, but does not identify the product as an AI offering.
- On the Cusp of a Revolution in Digital Monitoring (opens in a new tab)hitachirail.com
- Hitachi describes a six-month overhead-line monitoring trial beginning in May 2022 on LNER Azuma trains on the East Coast Main Line.
- The account describes machine-learning analytics and information for Network Rail, while presenting everyday maintenance adoption as a subsequent ambition.
- HMAX for Infrastructure | Hitachi Rail (opens in a new tab)hitachirail.com
- Hitachi markets HMAX for Infrastructure with AI-supported processing of pantograph and overhead-line video in partnership with NVIDIA.
- Hitachi Rail launches ‘Enhanced by HMAX’, committing to embed technology in all new rolling stock from 2027 (opens in a new tab)hitachi.com
- Hitachi's September 24, 2026 announcement describes HMAX catenary monitoring using onboard processing of footage from in-service trains.
- The commitment to embed HMAX technology in all new rolling stock from 2027 is forward-looking and concerns the broader platform, not a stated universal catenary deployment.
Regional Catenary Opportunities Depend on Project Status
North America. Caltrain's operating overhead-contact infrastructure contrasts with Canada's development-stage Alto initiative. The useful commercial distinction is installed-asset support versus prospective construction packages, rather than treating all electrification announcements as equivalent orders.
Latin America. Comparable buyer-level conclusions could not be established from the successfully inspected evidence. Brazil-focused official records were not retrievable, leaving concession-related overhead-line commitments, awards and delivery status unresolved. This is a reporting limitation, not evidence of limited regional activity.
Europe. SNCF's Dax–Bayonne catenary renewal and Deutsche Bahn's completed overhead-line work demonstrate purchasing needs beyond first-time electrification. These examples support examining replacement, compatibility and coordinated network works, without establishing uniform demand or procurement conditions across Europe.
Middle East. Etihad Rail describes a planned Abu Dhabi–Dubai high-speed service on a separate fully electrified network. That is a relevant project-development signal, but the inspected page does not identify an OCS supplier award. Electrification intent must remain separate from accessible catenary procurement.
Africa. Egypt illustrates integrated railway delivery. Siemens' November 10, 2025 disclosure records a first Desiro HC train run, development with Arab Contractors and Orascom Construction, and a maintenance commitment covering railway equipment. Those milestones do not establish completion of the whole network or a separately available OCS contract. The disclosed commercial structure favors attention to consortium and package boundaries.
Asia-Pacific. India's advanced broad-gauge electrification and JR East's announced equipment simplification highlight different buyer priorities: remaining conversion work and installed-network support in one case, maintenance burden and workforce constraints in the other. These examples should not be generalized into a single regional adoption pattern.
- Caltrain Program | SMCTA (opens in a new tab)smcta.com
- The San Mateo County Transportation Authority identifies Caltrain's overhead contact system as part of the electrification infrastructure and confirms the September 21, 2024 service launch.
- Real-time Assurance for the High-Speed Rail Initiative (opens in a new tab)tc.canada.ca
- Transport Canada's assurance report describes Alto as a dedicated electrified railway initiative that entered co-development after preferred-bidder selection in February 2025.
- The report distinguishes co-development from the subsequent construction phase.
- Les engagements du Groupe en Nouvelle-Aquitaine (opens in a new tab)groupe-sncf.com
- SNCF identifies catenary renewal between Bénesse-Maremne and Boucau on the Dax–Bayonne line, with SNCF Réseau and European Union co-financing.
- Entwicklung der Infrastruktur | Zwischenbericht Deutsche Bahn 2026 (opens in a new tab)zbir.deutschebahn.com
- Deutsche Bahn's 2026 interim report describes completed infrastructure work on Emmerich–Oberhausen, including new overhead line.
- High Speed (opens in a new tab)corporate.etihadrail.ae
- Etihad Rail describes a planned Abu Dhabi–Dubai high-speed passenger service on a separate fully electrified network.
- The inspected project page does not identify an awarded OCS supplier.
- Siemens Unveils Velaro High-Speed Train at TransMEA 2025 in Cairo (opens in a new tab)press.siemens.com
- Siemens' November 10, 2025 announcement reports a first Desiro HC train run in Egypt, describes development with Arab Contractors and Orascom Construction, and identifies a maintenance commitment covering railway equipment.
- The announcement describes commissioning as planned and does not establish completion of the entire network or an independently accessible OCS package.
- India Emerges as Global Leader in Railway Electrification with 99.6% Broad Gauge Network Electrified, Second Only to Switzerland (opens in a new tab)pib.gov.in
- India's Ministry of Railways reported near-complete broad-gauge electrification on July 22, 2026, while stating that remaining electrification had been taken up.
- 新しい電車線設備「SMART インテグレート架線」の導入による設備のスリム化・働き方改革の実現について (opens in a new tab)jreast.co.jp
- JR East's June 4, 2025 announcement links SMART Integrate Catenary introduction to equipment simplification, reduced maintenance and future workforce constraints.
Catenary Implications of the Assigned Geographic Groups
ASEAN. The commercial question is whether regional railway interoperability work changes supplier qualification or purchasing conditions. Official interoperability-plan material was located but could not be retrieved for substantive inspection. Consequently, this review does not establish an implemented ASEAN-wide catenary requirement, common approval route or procurement program.
BRICS. The relevant question is whether transport cooperation has produced funded, identifiable OCS opportunities rather than general infrastructure commitments. The transport-declaration material and related official publication were not successfully inspected. National railway activity must therefore remain separate from any unsubstantiated bloc-level commercial proposition.
European Union. A European Union Agency for Railways study released in May 2026 identifies continued electrification-related interoperability barriers and recommends against blanket conversion of existing DC lines to AC during renewal or upgrading. These are study recommendations, not proof that regulations have changed. Commercially, compatibility with legacy networks remains a more defensible positioning principle than assuming one fully harmonized replacement product.
G7. Canada's G7 accountability report describes the Partnership for Global Infrastructure and Investment as a framework for mobilizing public and private quality-infrastructure investment. That can be relevant to project financing, but the broad framework is not an OCS order. Suppliers should distinguish financing initiatives from the subsequent buyer, contract scope and award.
GCC. The GCC Secretariat's July 2025 progress review establishes coordination around the GCC Railway project. It does not establish an overhead-catenary award or common traction architecture across every segment. The separately planned electrified UAE high-speed network is a project-specific opportunity, not evidence that the entire GCC railway program requires OCS.
NATO. No usable inspected record established an alliance-wide catenary procurement requirement or attributable OCS award. Defence-related transport priorities cannot, on that basis alone, be counted as secured catenary demand; the missing fact is a named infrastructure owner's funded overhead-line package.
- Study on the harmonisation of electrification systems (opens in a new tab)op.europa.eu
- The European Union Agency for Railways study identifies electrification-related interoperability barriers and recommends against an absolute requirement to convert existing DC lines to AC during upgrade or renewal.
- The publication was released on May 22, 2026; its recommendations are not themselves evidence of adopted regulatory changes.
- High Speed (opens in a new tab)corporate.etihadrail.ae
- The UAE project is a project-specific electrification intention and does not establish the traction architecture of every GCC railway segment.
- HE the GCCSG: The GCC States are Keen to Complete the GCC Railway Project as Planned, to Achieve Further Development & Prosperity for their Peoples (opens in a new tab)gcc-sg.org
- The GCC Secretariat's July 16, 2025 record describes a GCC Railway progress review involving the GCC Railways Authority and coordination among member states.
- The inspected record does not establish an OCS award or common traction technology across all project segments.
- G7 Canada 2025 Comprehensive Accountability Report (opens in a new tab)international.canada.ca
- The G7 accountability report describes the Partnership for Global Infrastructure and Investment as a framework for mobilizing public and private investment in quality infrastructure.
- That broad financing framework does not itself identify an OCS order.
Catenary Purchasing Conditions in the Featured Countries
Australia. Sydney Metro's City & Southwest disclosures include station conversion and completion of overhead wiring within a wider contract scope. This supports a package-led commercial approach rather than assuming that every component is purchased directly by the transport authority. Current subcontract awards were not established.
Brazil. Official São Paulo planning material could not be substantively inspected. Responsibility for concession-related overhead-line investment, awarded supplier scope and implementation status therefore remain unresolved. This evidence gap does not establish weak demand or an inactive market.
Canada. Transport Canada identifies Cadence as the private developer partner selected on February 19, 2025. Its assurance report distinguishes Alto's co-development phase from subsequent construction. The disclosed relationship establishes development access, not an OCS supply award.
China. Native-language official project and procurement records were located but were not successfully retrieved for substantive inspection. This review therefore makes no supplier-award, foreign-entry or current commercial-availability claim for China.
France. SNCF identifies catenary renewal between Bénesse-Maremne and Boucau on the Dax–Bayonne line, with SNCF Réseau and European Union co-financing. This supports a renewal-oriented buyer need, but the disclosure does not establish an open supplier opportunity.
Germany. Deutsche Bahn's 2026 interim report describes the May 2026 completion of the Emmerich–Oberhausen construction period, including newly installed overhead line. This is evidence of realized infrastructure work rather than merely planned investment; remaining supplier-access questions require package-level records.
India. The Ministry of Railways reported near-complete broad-gauge electrification on July 22, 2026. The commercial implication is to examine remaining conversion work alongside support for the installed network. Network coverage alone does not establish future replacement expenditure or individual awards.
Italy. Alstom's Valmadrera site was assigned component design and supply for the April 2025 Türkiye rigid-catenary agreement. This establishes an Italian supply and export role; it should not be presented as evidence of equivalent domestic Italian purchasing demand.
Japan. JR East's June 4, 2025 announcement identifies SMART Integrate Catenary introduction in its Takasaki branch area, with equipment simplification and reduced maintenance as objectives. It describes sequential introduction; the inspected announcement does not establish the subsequent extent of rollout or supplier revenue.
Mexico. The official El Insurgente progress record could not be retrieved for substantive inspection. Completion of the relevant catenary scope, current purchasing responsibility and supplier awards remain unsubstantiated in this review.
Russia. RZD-Partner attributes contact-network renewals during 2025 to Russian Railways. This secondary account supports an attributed renewal observation, but identifies neither component suppliers nor commercial access for a particular foreign provider. It is not equivalent to an inspected operator award record.
South Korea. Korea National Railway's September 2026 project status places the Mungyeong–Gimcheon electrified railway in design. This supports monitoring a development-stage opportunity, not assuming an awarded component package or immediate product demand.
Spain. Elecnor's October 7, 2025 announcement identifies a consortium comprising Elecnor Servicios y Proyectos, Syneox Rail, Electren and Comsa as the awardee for Basque high-speed catenary installation. The disclosed consortium is the relevant commercial channel; an award is not proof of completed delivery.
United Kingdom. HS2's OCS structure identifies contractor-led component purchasing under a licensed design. For a component specialist, access through that supply chain is commercially distinct from competing for the complete infrastructure package.
United States. The San Mateo County Transportation Authority confirms Caltrain's OCS infrastructure and electrified-service launch on September 21, 2024. This establishes an operating asset base, but not a new replacement-component order or an unrestricted aftermarket opportunity.
- Alstom signs contract with RESA Yapi Elektromekanik A.S. to supply the first Rigid Overhead Catenary System for Türkiye's new high-speed line (opens in a new tab)alstom.com
- Alstom's Valmadrera site in Italy was assigned component design and supply, and the announcement describes the site's railway-electrification materials business as serving export markets.
- Railway systems - HS2 (opens in a new tab)hs2.org.uk
- HS2's disclosed contracting structure identifies a contractor-led component-supply channel for the United Kingdom project.
- Caltrain Program | SMCTA (opens in a new tab)smcta.com
- Caltrain's operating electrification project establishes an installed OCS asset base in the United States, rather than evidence of a new component order.
- High-Speed Rail Initiative from Toronto to Québec City (opens in a new tab)tc.canada.ca
- Transport Canada states that Cadence was announced as the private developer partner on February 19, 2025, for the initiative's next development phase.
- Les engagements du Groupe en Nouvelle-Aquitaine (opens in a new tab)groupe-sncf.com
- The French project is a renewal example; its disclosure does not establish an open supplier opportunity.
- Entwicklung der Infrastruktur | Zwischenbericht Deutsche Bahn 2026 (opens in a new tab)zbir.deutschebahn.com
- The report states that the construction period on Emmerich–Oberhausen concluded in May 2026, providing evidence of realized German overhead-line work.
- India Emerges as Global Leader in Railway Electrification with 99.6% Broad Gauge Network Electrified, Second Only to Switzerland (opens in a new tab)pib.gov.in
- The ministry's network-status disclosure does not establish the value of future OCS replacement orders or individual supplier awards.
- 新しい電車線設備「SMART インテグレート架線」の導入による設備のスリム化・働き方改革の実現について (opens in a new tab)jreast.co.jp
- The announcement identifies the Takasaki branch area for JR East's initial introduction and describes operations as beginning sequentially.
- City and Southwest planning and compliance | Sydney Metro (opens in a new tab)sydneymetro.info
- Sydney Metro's City & Southwest planning and compliance page describes a contract scope including station conversion and completion of overhead wiring and track-alignment work.
- 사업소개 - 철도건설 - 일반철도 - 주요사업현황 (opens in a new tab)kr.or.kr
- Korea National Railway's project-status page identifies the Mungyeong–Gimcheon electrified railway project as being in design in its September 2026 status.
- The project-stage disclosure does not establish a component-supplier award.
- РЖД в 2025 году обновили и отремонтировали более 4,2 тыс. км железнодорожного пути (opens in a new tab)rzd-partner.ru
- RZD-Partner attributes its report of contact-network renewals during 2025 to Russian Railways; the article does not identify OCS component suppliers.
- Adjudicada la instalación de la catenaria del AVE vasco con participación de Elecnor (opens in a new tab)grupoelecnor.com
- Elecnor's October 7, 2025 announcement identifies Elecnor Servicios y Proyectos, Syneox Rail, Electren and Comsa as the consortium awarded the Basque high-speed catenary installation contract tendered by Adif.
Conditional Commercial Choices for Catenary Suppliers
Choose the contracting role before expanding the portfolio. HS2's licensed-design structure supports pursuing qualified component supply as an alternative to systems-prime responsibility. The trade-off is narrower package control versus lower delivery exposure. Move toward prime contracting only when the disclosed scope, counterparty responsibilities and commercial risk allocation justify it.
Stage investment around procurement status. Alto's co-development phase and Etihad Rail's planned electrified network support business development, not assumptions of secured OCS sales. Flexible partnerships are preferable to irreversible local investment where package boundaries remain unresolved. A named OCS award, clear purchasing responsibility and repeat-order visibility would strengthen the case for inventory or a permanent establishment.
Balance first-time electrification with installed-network support. Germany's completed overhead-line work and India's advanced electrification status support positioning around renewal, compatibility and lifecycle support as well as new construction. The alternative is a new-build-only offering. Change that balance when published owner programs and awarded scopes—not national rail ambitions alone—show a different purchasing mix.
Commercialize AI against attributable customer value. HMAX provides a market-specific monitoring proposition. Consider partnerships or service bundles only where data rights, customer responsibilities and paid deployment references are clear. Buying an established platform may accelerate access, while increasing vendor dependence; developing one internally requires a credible commercial customer base. Neither option is justified by broad AI adoption claims alone.
Reconfirm channels after ownership changes. The historical Australian Tensorex arrangement described support only through January 2025. Do not treat that record as a current exclusivity agreement. Prefer reversible channel commitments until present counterparty roles and product rights are established.
- Pfisterer Rail Equipment acquisition by Mosdorfer / Knill Group, and ongoing equipment supply in Australia (opens in a new tab)mosdorfergraph.com.au
- The announcement described an Australian Tensorex distribution and support arrangement extending only until January 2025; it does not establish the current arrangement.
- Railway systems - HS2 (opens in a new tab)hs2.org.uk
- The licensed-design procurement structure is the factual basis for the report's conditional recommendation to distinguish component supply from systems-prime participation.
- HMAX for Infrastructure | Hitachi Rail (opens in a new tab)hitachirail.com
- The documented overhead-line offering provides a market-specific basis for considering monitoring services, without independently establishing customer savings.
- Real-time Assurance for the High-Speed Rail Initiative (opens in a new tab)tc.canada.ca
- The development-versus-construction distinction supports stage-gated commercial investment rather than treating the project as an awarded OCS package.
- Entwicklung der Infrastruktur | Zwischenbericht Deutsche Bahn 2026 (opens in a new tab)zbir.deutschebahn.com
- The disclosed completed work supports considering renewal and network-expansion propositions alongside first-time electrification.
- High Speed (opens in a new tab)corporate.etihadrail.ae
- The planned network provides a basis for monitoring procurement, rather than assuming secured catenary demand.
- India Emerges as Global Leader in Railway Electrification with 99.6% Broad Gauge Network Electrified, Second Only to Switzerland (opens in a new tab)pib.gov.in
- The advanced electrification status is the factual basis for considering installed-network support alongside remaining first-time conversion work.
Overhead Catenary Research Methods and Evidence Limits
This qualitative review was prepared with a research cutoff of October 26, 2026. Successfully inspected material included supplier portfolios, ownership announcements, infrastructure-owner disclosures, development-stage assurance reports, project-status records and supplier award announcements. Historical acquisition and trial records were retained where they explained present commercial distinctions.
Records were compared by entity, geography, date and status: marketed offering, announced introduction, development partnership, awarded package, completed work or operating asset. Native-language material was inspected for France, Germany, Japan, South Korea, Spain and Russia. The Russian renewal example relies on a trade publication attributing information to the operator, rather than an independently inspected operator filing.
Several official records could not be retrieved for substantive inspection. The resulting Brazil, China, Mexico, ASEAN, BRICS and NATO limitations are identified in their assigned sections; failed retrieval was not treated as evidence of inactivity. Evidence is strongest for mainline and urban-rail applications and is not an exhaustive register of every overhead-contact application.
No interviews, surveys, statistical validation or market-sizing calculations were performed. Supplier benefits remain attributed claims, not independently demonstrated outcomes. Group membership was not inferred from the supplied catalog, and overlapping geographies were not treated as additive markets.
Catenary Prospects Favor Clear Roles and Observable Milestones
The supported commercial picture is a mixture of new infrastructure, installed-asset renewal, licensed designs and monitoring services—not a uniform global construction cycle. Ownership of products, control of purchasing packages and compatibility with existing networks can matter as much as a supplier's breadth of portfolio.
The most useful milestones are observable public events: identifiable OCS procurement following Canada's development phase, subsequent deployment and purchasing disclosures after JR East's equipment announcement, and attributable paid catenary references as HMAX expands. Each would strengthen a commercial case without guaranteeing success.
Industry leaders should therefore distinguish announced potential, awarded scope and realized use when allocating resources. The unresolved country and group evidence limits comparative confidence, especially where official records could not be inspected; it should not be converted into a forecast of either growth or inactivity.
- Hitachi Rail launches ‘Enhanced by HMAX’, committing to embed technology in all new rolling stock from 2027 (opens in a new tab)hitachi.com
- The announcement supports monitoring deployment milestones as relevant outlook indicators, but does not establish market-wide paid catenary adoption.
- Real-time Assurance for the High-Speed Rail Initiative (opens in a new tab)tc.canada.ca
- Progress from co-development toward separately identifiable construction procurement is an observable commercial milestone.
- 新しい電車線設備「SMART インテグレート架線」の導入による設備のスリム化・働き方改革の実現について (opens in a new tab)jreast.co.jp
- Subsequent confirmation of deployment and further procurement would strengthen the commercial interpretation beyond the original announcement.
Research report
Table of contents
- 1.Preface
- 1.1Objectives of the Study
- 1.2Market Definition
- 1.3Market Segmentation & Coverage
- 1.4Years Considered for the Study
- 1.5Currency Considered for the Study
- 1.6Language Considered for the Study
- 1.7Key Stakeholders
- 2.Research Methodology
- 2.1Introduction
- 2.2Research Design
- 2.2.1Primary Research
- 2.2.2Secondary Research
- 2.3Research Framework
- 2.3.1Qualitative Analysis
- 2.3.2Quantitative Analysis
- 2.4Market Size Estimation
- 2.4.1Top-Down Approach
- 2.4.2Bottom-Up Approach
- 2.5Data Triangulation
- 2.6Research Outcomes
- 2.7Research Assumptions
- 2.8Research Limitations
- 3.Executive Summary
- 3.1Introduction
- 3.2CXO Perspective
- 3.3New Revenue Opportunities
- 3.4Next-Generation Business Models
- 3.5Industry Roadmap
- 4.Market Overview
- 4.1Introduction
- 4.2Key Growth Contribution
- 4.3Industry Ecosystem & Value Chain Analysis
- 4.3.1Supply-Side Analysis
- 4.3.2Demand-Side Analysis
- 4.3.3Stakeholder Analysis
- 4.4Market Dynamics
- 4.4.1Key Drivers
- 4.4.2Key Restraints
- 4.4.3Key Opportunities
- 4.4.4Key Challenges
- 4.5Porter’s Five Forces Analysis
- 4.6PESTLE Analysis
- 4.7Market Outlook
- 4.7.1Near-Term Market Outlook (0-2 Years)
- 4.7.2Medium-Term Market Outlook (3-5 Years)
- 4.7.3Long-Term Market Outlook (5-10 Years)
- 4.8Go-to-Market Strategy
- 5.Market Insights
- 5.1Consumer Insights & End-User Perspective
- 5.2Consumer Experience Benchmarking
- 5.3Opportunity Mapping
- 5.4Distribution Channel Analysis
- 5.5Pricing Trend Analysis
- 5.6Regulatory Compliance & Standards Framework
- 5.7ESG & Sustainability Analysis
- 5.8Disruption & Risk Scenarios
- 5.9Return on Investment & Cost-Benefit Analysis
- 6.Cumulative Impact of Artificial Intelligence 2026
- 7.Overhead Catenary System Market, by Region
- 7.1Introduction
- 7.2Asia-Pacific
- 7.3North America
- 7.4Latin America
- 7.5Europe
- 7.6Middle East
- 7.7Africa
- 8.Overhead Catenary System Market, by Group
- 8.1Introduction
- 8.2ASEAN
- 8.3GCC
- 8.4European Union
- 8.5BRICS
- 8.6G7
- 8.7NATO
- 9.Overhead Catenary System Market, by Country
- 9.1Introduction
- 9.2United States
- 9.3Canada
- 9.4Mexico
- 9.5Brazil
- 9.6United Kingdom
- 9.7Germany
- 9.8France
- 9.9Russia
- 9.10Italy
- 9.11Spain
- 9.12China
- 9.13India
- 9.14Japan
- 9.15Australia
- 9.16South Korea
- 10.Competitive Landscape
- 10.1Market Share Analysis, 2025
- 10.2Market Concentration Analysis, 2025
- 10.3Recent Developments & Impact Analysis, 2025
- 10.4Product Portfolio Analysis, 2025
- 10.5Benchmarking Analysis, 2025
- 11.Companies Covered
- 12.Key Experts
